Coachman Service Center - New service garage

  • Coachman Service Center - New service garage

    Updated on 12/13/22

    Project information:

    Architect: Sweet Sparkman Architecture

    Contractor: Creative Contractors, Inc.

    CM Project Website: https://coachmanservicecenter.shutterfly.com/

    PCSB Project Coordinator: Bruce Stott

    Project Budget: $6.5 Million

    Start Date: December 2021

    Completion: April 2023



    Construction/Renovation of:

    The project includes a new bus service garage to hold and maintain the buses servicing our mid county schools.   The project’s goal is to construct a new bus service garage with associated work spaces to be located at the south-east of the property, a remodel of the existing facilities kitchen area to turn it from the transportation command center back into a kitchen to serve the school.   There will also be site work associated with the project to include a revised parking lot layout and drive access.

    Demolition will include:

    • Demolition of Building 1



    New Construction will include:

    • New bus service garage to include:
      • 5 bay service garage: 5,475 Sq.Ft
      • Flammable storage: 450 Sq.Ft.
      • Tool Room: 900 Sq.Ft.
      • Garage Foreman/Clerk/Lead Mechanic: 500 Sq.Ft.
      • Parts Room/Parts Office : 1,700 Sq.Ft.
      • 5 Offices: 750 Sq.Ft.
      • Bus Service Recorder: 250 Sq.Ft.
      • Restrooms: 900 Sq.Ft.
      • Lounge: 1,000 Sq.Ft
      • Mechanical/Electrical/Comm.: 850 Sq.Ft
      • Clerical/Storage/Vault: 600 Sq.Ft

    Total:                                                                                             13,375 Sq.Ft.

    • New Transportation Command Center: 2,400 Sq.Ft.



    Renovations and remodel to include:

    • Converting the existing Transportation Command Center back into a working kitchen
    • Remodel existing school auditorium (ceilings, lights, flooring, paint)



    Site Work:

    • Create new parking lot layout and entry drive for the buses and staff parking

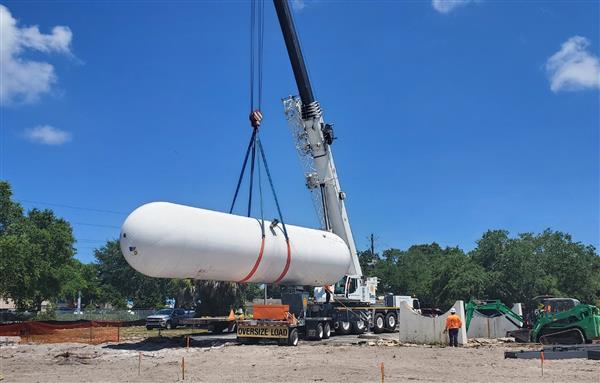

    • Add additional propane fueling stations for buses.

    Project status:



    • Completed Last Week:
    • Completed installation of new signage at transportation offices in Building #2.
    • Continued final grading and asphalt for southwest end of site.
    • Completed installation of new asphalt south of existing Building #2 and Building #3.
    • Continued footers and sidewalk for covered walkway.
    • Continued hanging light fixtures in new service building.

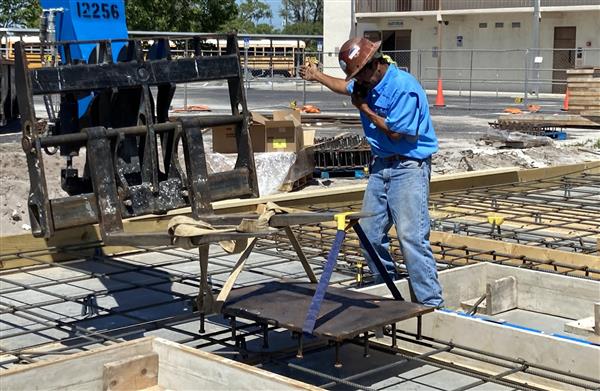

    • Continued rough in of mechanical controls and low voltage electrical for new service building.
    • Began electrical and mechanical trim on interior of new service building.
    • Continued removal of excess spoils from site.
    • Completed priming and painting of stair railing. Continued touch up paint on interior of service building.
    • Completed installation of safety gate at mezzanine.
    • Began installation of lockers in Restrooms #104 & #106.



    • Scheduled This Week:
    •  Continue final grading and asphalt for southwest end of site.
    •  Continue footers and sidewalk for covered walkway.
    •  Continue rough in of mechanical controls and low voltage electrical for new service building. .
    •  Continue hanging light fixtures in new service building.
    •  Complete installation of condenser units on south exterior of new service building.
    •  Complete priming and painting of ship ladder to roof hatch.
